Project management is a multifaceted discipline that necessitates meticulous planning and execution. Among the techniques employed by project managers, the Critical Path Method (CPM) helps identify the dependencies that determine a schedule. This guide will explore CPM, including its definition, benefits, and practical application steps. We will also address common questions about this planning technique and work through a six-task example. You can use Boardmix for visual project planning to discuss those dependencies with your team.
Part 1. What Is the Critical Path Method in Project Management?
The Critical Path Method (CPM) is a project management technique that involves detailed, step-by-step process planning. It distinguishes between critical and non-critical tasks, thereby providing a clear roadmap for the project's execution. The primary objective of CPM is to understand how dependent activities affect the schedule. By identifying the longest stretch of dependent activities and measuring them from start to finish, it determines the earliest completion time under the model's assumptions. Managers must still check resources, working calendars, and risks before committing to a delivery date: CPM does not prevent delays or guarantee timely completion.
Part 2. Benefits of Using the Critical Path Method
The Critical Path Method (CPM) helps teams understand how individual tasks affect the overall project schedule.
- Improved Efficiency: CPM helps to identify the most time-sensitive tasks, allowing managers to focus their efforts where it matters most and thereby improve overall efficiency.
- Better Task Prioritization: By distinguishing between critical and non-critical tasks, CPM supports scheduling decisions. A non-critical task can still be important for safety, quality, or business value.
- Enhanced Risk Assessment: CPM provides a clear view of potential bottlenecks and delays, helping managers plan risk mitigation strategies.
- Better-Informed Resource Allocation: Float can show where there is scheduling flexibility, but CPM alone does not calculate staffing needs or optimize costs. Resource leveling separately checks whether the required people and equipment are available; this may change the schedule.
- Clear Visibility of Project Timeline: By mapping out every task from start to finish, CPM offers clear visibility of the project timeline, keeping stakeholders informed about the planned sequence and expected completion date.
Part 3. Steps to Use the Critical Path Method

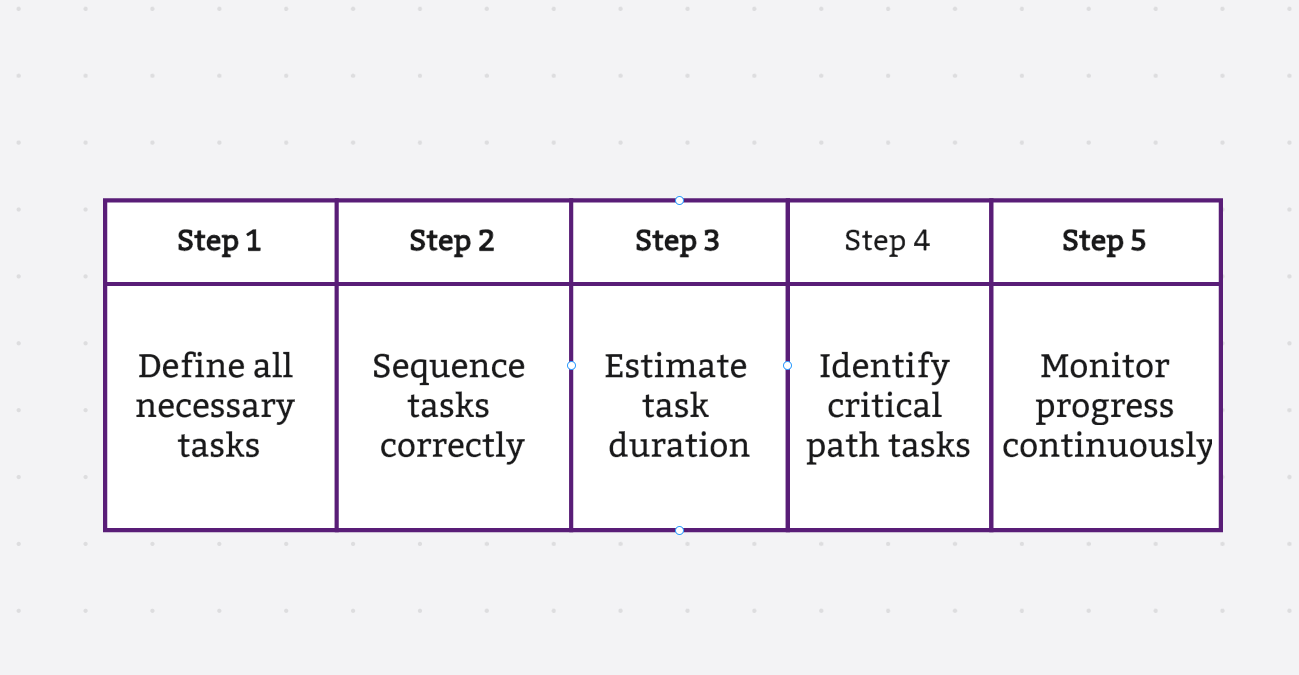

Implementing the Critical Path Method (CPM) involves a systematic process that can be broken down into the following steps:
- Define all necessary tasks: The first step in CPM is to identify and list all the tasks required to complete the project. This includes everything from initial planning to final delivery.
- Sequence tasks correctly: Once all tasks are identified, they need to be sequenced in the correct order of execution. This step involves understanding task dependencies and determining which tasks must precede others.
- Estimate task duration: Estimate how long each task will take under the stated working conditions. Record assumptions and any contingency separately so that the same allowance is not counted twice.
- Identify critical path tasks: The critical path is determined by identifying the longest sequence of dependent tasks from start to finish. These are the tasks that directly affect the project's calculated completion date.
- Monitor progress continuously: Once the project begins, it's essential to monitor progress against the planned schedule and make adjustments as needed based on actual performance.
Calculate the two paths in the diagram
For the six-task diagram above, suppose the tasks have the durations below. Both paths start at day 0, each task starts when its predecessor finishes, and the project ends when both paths are complete. Assume one shared working calendar, no resource conflicts, and no additional constraints.
| Task | Predecessor | Duration (days) | Earliest finish (day) |
|---|---|---|---|
| 1 | Start | 3 | 3 |
| 2 | 1 | 4 | 7 |
| 3 | 2 | 2 | 9 |
| 4 | Start | 2 | 2 |
| 5 | 4 | 2 | 4 |
| 6 | 5 | 3 | 7 |
Tasks 1 → 2 → 3 take 3 + 4 + 2 = 9 days. Tasks 4 → 5 → 6 take 2 + 2 + 3 = 7 days. The upper path is critical; the lower path has two days of scheduling flexibility before it delays the project finish. That two-day allowance is shared along the lower path, not an extra two days that every task can use independently.
PMI's explanation of CPM calculations distinguishes total float from free float. Total float is the delay allowed without moving the project finish; free float is the delay allowed without moving the next activity's early start. Here, delaying task 4 by one day moves task 5's early start but still leaves the project finishing on day 9. If task 6 instead takes six days, the lower path becomes 10 days and becomes the critical path.
Part 4. How Boardmix Helps You with the Critical Path Method

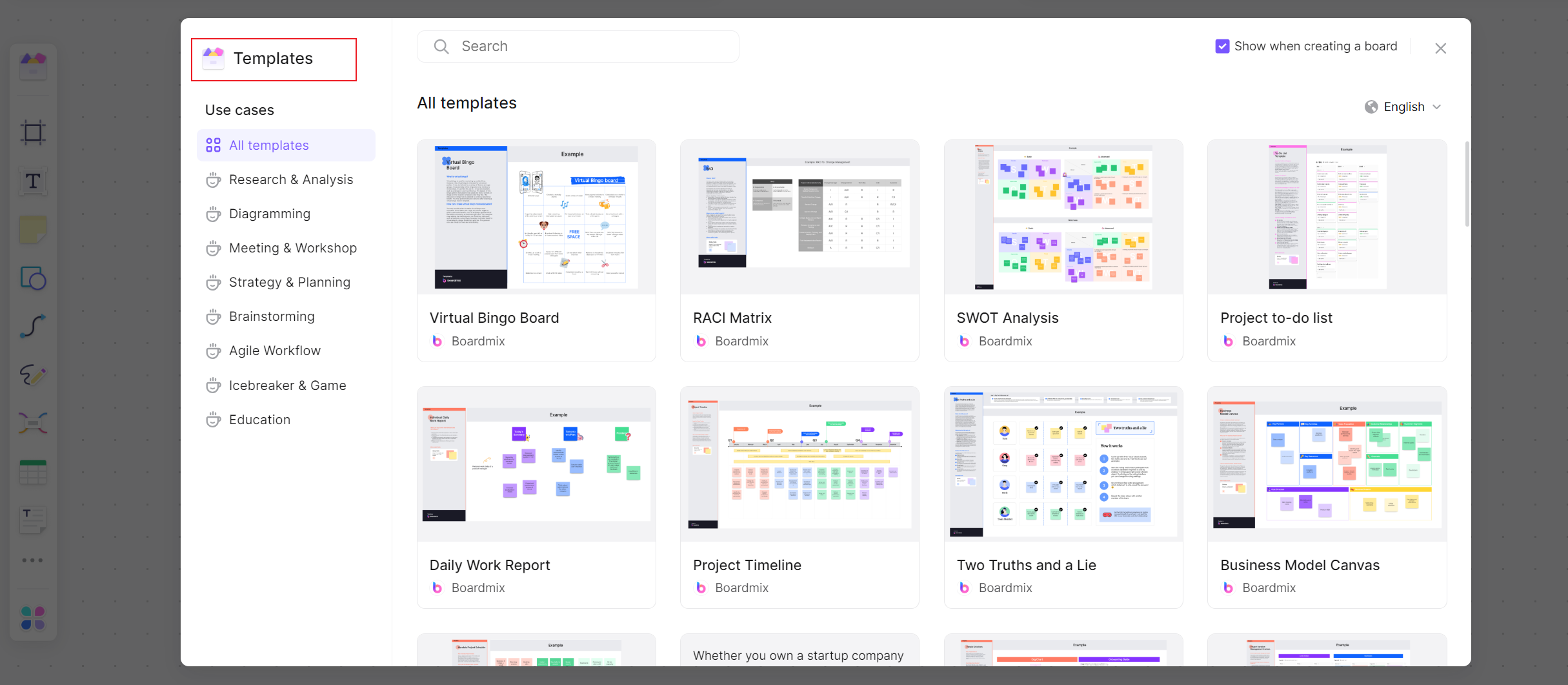

Boardmix is an online whiteboard tool for visually mapping out your project plan. With Boardmix, you can delineate tasks, sequence them appropriately, and mark a critical path after calculating the schedule. Boardmix also promotes team collaboration by providing a shared workspace where team members can brainstorm ideas, provide feedback, and work together in real time. The board can be adjusted as the plan changes. Its template library offers starting layouts for project planning; the screenshot below shows that library, not an automatically calculated CPM schedule.
To map the worked example, place tasks 1–3 in one row and tasks 4–6 in another. Label each task with its duration, connect the dependencies, and write the two path totals beside them. Mark the nine-day path after calculating it yourself or in a scheduling tool. Keep the assumptions and calculation sheet with the board so teammates can check the figures when a duration changes. Boardmix supports the visual discussion; these steps do not depend on automatic critical-path calculation.
FAQs about the Critical Path Method in Project Management
1. What is a critical path in project management?
A critical path in project management refers to the sequence of tasks that must be completed on time for the entire project to be delivered on schedule. In the unconstrained example above, it is the longest path and its tasks have no total float. More than one path can be critical if their durations are equal.
2. How do you calculate the critical path?
Calculating a critical path involves listing all tasks required to complete the project, estimating their durations, noting dependencies between tasks, then determining the longest path through these dependent tasks. Where paths join, the next task must wait for the latest-finishing predecessor. A backward pass can then establish the latest start and finish dates and total float.

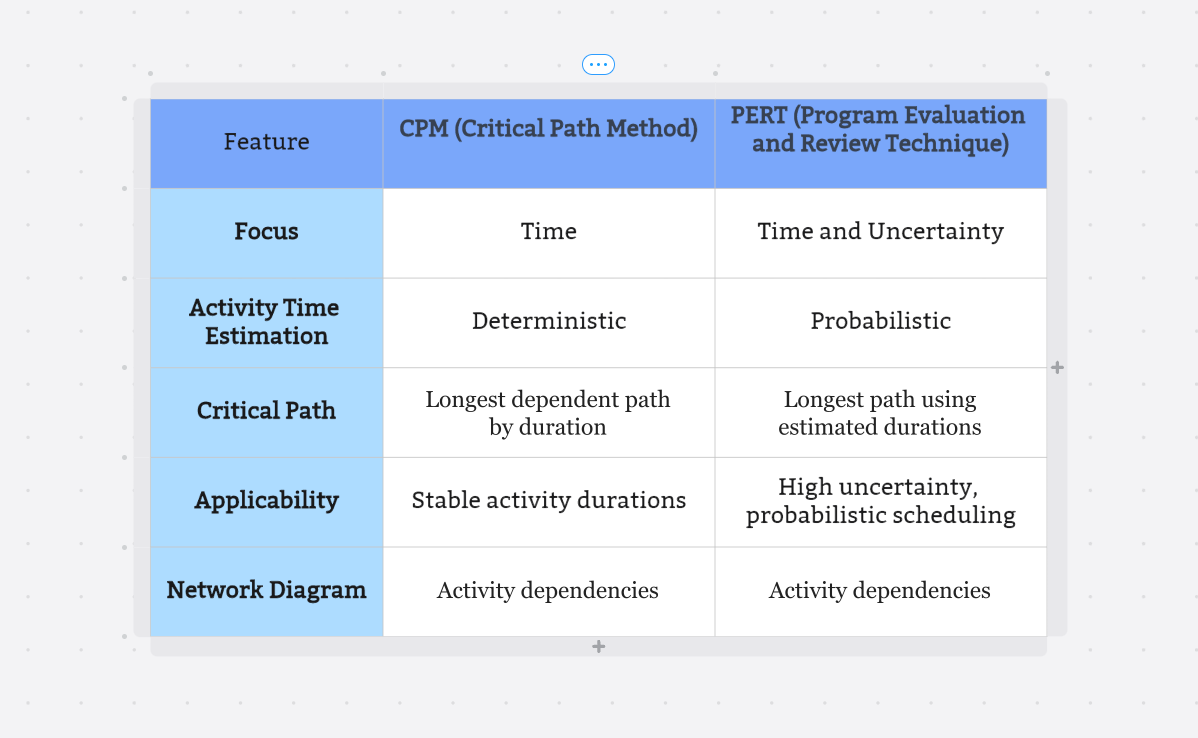

3. What is the difference between CPM and PERT?
CPM uses a single duration for each activity in a schedule calculation. PERT uses optimistic, most likely, and pessimistic estimates to represent uncertainty in activity duration. The traditional PERT weighted estimate is (optimistic + 4 × most likely + pessimistic) ÷ 6. Those estimates can feed a dependency-network calculation; PERT does not replace dependencies with probabilities or guarantee a completion date.
Open the full-size CPM and PERT comparison
